Metal fabrication outside-processing delays: route late returns to the right job owner

When a processor returns heat-treated parts late or in a split shipment, one shared case shows the unresolved quantity, the affected next operation and who decides the allocation.

Author
Ignacio Malpartida · GTM Engineer
Published
Read time
4 min read
Metal fabrication outside-processing delays: route late returns to the right job owner
APP TIPS

The operating decision

An outside-processing delay workflow should identify which sent batches remain unresolved, which downstream jobs need them and who can approve a recovery plan. Compare the subcontractor’s latest confirmation with the internal requirement, then coordinate purchasing and planning follow-up. Keep expected return, carrier movement, physical receipt and inspection acceptance separate. The workflow is complete when the affected job has accepted material or an approved alternative, not when a reminder has been sent.

Explore the complete metal fabrication and machining integration and automation hub for the systems and processes around this guide.

Summary card: Outside-processing delay workflow for NetSuite and Postgres

What this looks like in metal fabrication and machining

A shop outsources heat treatment for three jobs. The processor confirms that one batch will return late but can split the shipment. A buyer currently forwards that email to several planners, each of whom may call the supplier independently. A shared delay case can collect the sent quantities, required return dates, existing responses and affected operations. Purchasing can request one coherent recovery plan, while planners decide whether a partial return changes their schedules and who should receive the limited available quantity.

Records, ownership, and update rules

RecordOwnerOperating rule
Delay caseSubcontract purchasingTie the issue to a processor, operation and sent-batch identity with a named follow-up owner.
Required returnProduction planningPreserve the date and quantity needed for the next operation rather than relying only on the customer ship date.
Supplier recovery proposalPurchasingRecord the offered split quantity, date and transport conditions as a proposal awaiting internal acceptance.
Job allocation decisionPlanningIdentify which job receives the recovered quantity and retain approval when priorities change.

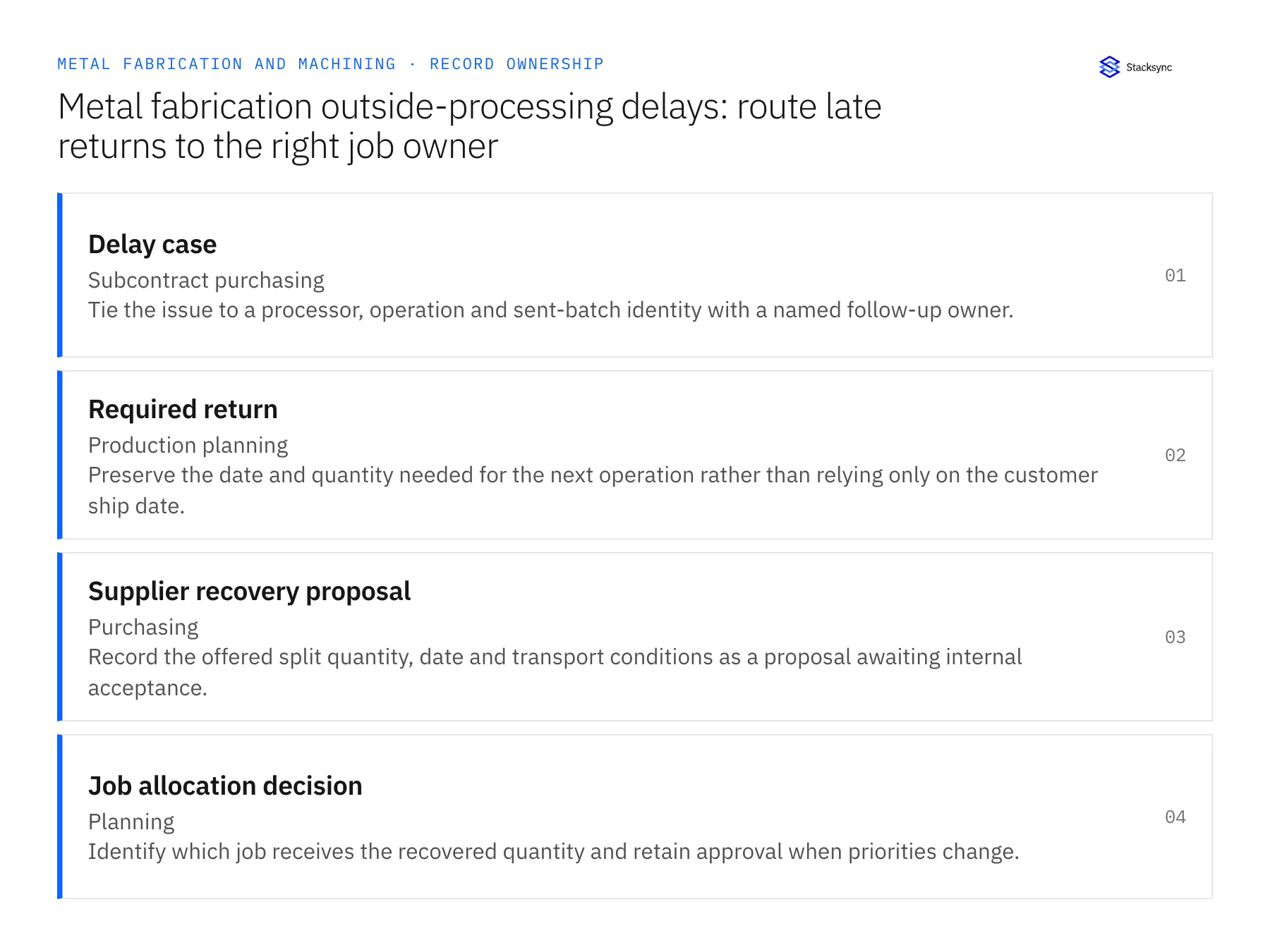

Record ownership diagram: Delay case, Required return, Supplier recovery proposal
Define the record owner and the rule before enabling updates.

Work through the process

  1. 01
    Find the actionable outstanding quantity
    Calculate unresolved sent quantity from dispatches, receipts and agreed dispositions. Exclude batches already received but still awaiting inspection from the supplier-late queue; they need a quality or receiving follow-up instead.
  2. 02
    Assemble one supplier conversation
    Attach the latest confirmation and prior follow-ups to the case. Identify the buyer authorized to coordinate the supplier response. This avoids multiple planners requesting incompatible delivery promises against the same constrained batch.
  3. 03
    Evaluate the proposed recovery
    Show downstream operations, requested quantities and available alternatives to planning. If the processor offers a split return, ask which jobs it should cover. Capture any approved transport or process change before communicating an accepted plan.
  4. 04
    Follow the batch through acceptance
    Track the revised commitment, dispatch evidence, receipt and required inspection. Escalate when a promised milestone is missed. Close only the quantity actually resolved and keep the remainder open under the same traceable case.

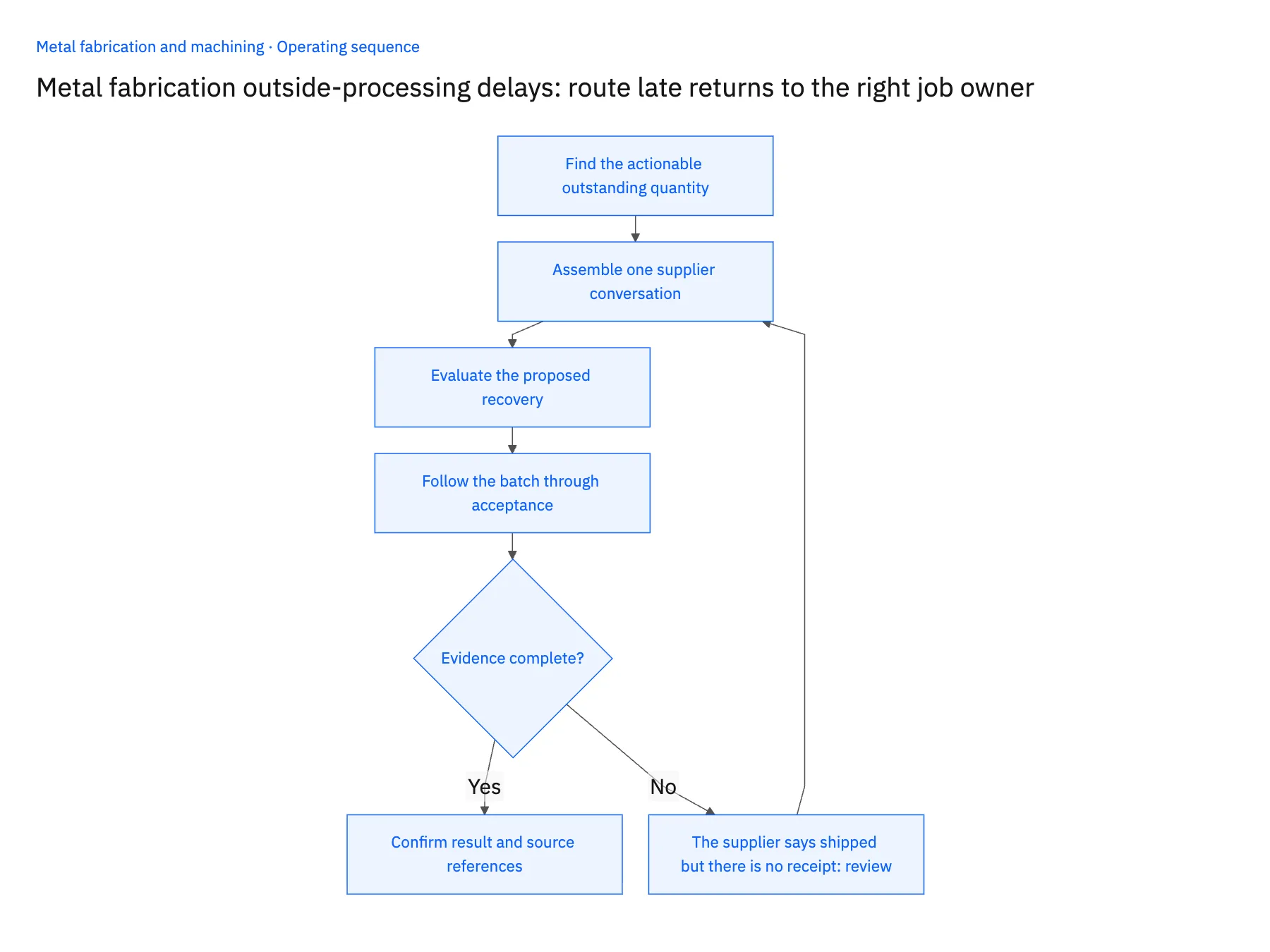

4-step operating sequence: Outside-processing delay workflow for NetSuite and Postgres
Follow the operating sequence; unresolved exceptions return to a responsible reviewer.

Handle the exceptions explicitly

The supplier says shipped but there is no receipt

Keep the case in transit or awaiting receipt and retain the relevant evidence. Shipping confirmation does not make the parts available to the next operation.

Two jobs compete for a partial return

Route allocation to the planner who owns prioritization. Do not divide the batch automatically merely to clear both overdue flags.

The returned work is rejected

Create the appropriate quality disposition and reconnect the unresolved quantity to the delay case so purchasing does not assume recovery is complete.

What to verify before expanding

  • Each late quantity has one current supplier-follow-up owner.
  • A partial recovery closes only the accepted quantity and leaves the balance visible.
  • Planners can see the next operation affected by the delay.
  • Supplier shipment confirmation cannot mark inspection-dependent work ready.
Book a demo for metal fabrication and machining integration and automation

Connect this process to the rest of your operation

Explore Stacksync workflows and scope the records and actions against your actual systems. Book a demo with a real delay case example and the exception your team handles most often, for example the supplier says shipped but there is no receipt.

The shared architecture guide covers record matching, ownership, and recovery across systems.

Technical references

Book a demo for metal fabrication and machining integration and automation

FAQ

Frequently asked questions

Should every overdue batch generate another email?
No. Use the current commitment and open conversation to decide when follow-up is due. Repeated reminders without new evidence can create noise while hiding the real unresolved decision.
Can the workflow choose another subcontractor?
It can assemble alternatives from approved information. Purchasing, engineering and quality must decide whether another processor is authorized for the affected operation.
What should purchasing track about late outside-processing batches?
Measure manual coordination touches, overdue confirmation age and the time from delay discovery to an accepted recovery plan. Compare similar outsourced operations rather than all supplier activity.
