Skip to content

Supplier-delay workflows for manufacturers: connect PO confirmations to customer commitments

A supplier-delay workflow keeps requested, confirmed and accepted dates apart, finds supply already on its way and prepares expedite or transfer options for the owner to approve.

Author
Ignacio Malpartida · GTM Engineer
Published
Read time
4 min read
Supplier-delay workflows for manufacturers: connect PO confirmations to customer commitments
APP TIPS

The operating decision

A manufacturing supplier-delay workflow should connect a changed purchase-order confirmation to the jobs and customer commitments that depend on it. Keep requested, supplier-confirmed and internally accepted dates separate. Automation can collect current supply, demand and follow-up history, then route a recovery decision to purchasing and planning. It should not create another purchase order or promise expedited delivery merely because a component appears late in one system.

Explore the complete manufacturing integration and automation hub for the systems and processes around this guide.

Summary card: NetSuite supplier delay workflow for manufacturing POs

What this looks like in manufacturing

A machine builder receives a supplier email moving a motor delivery by a week. Purchasing knows the delay, but the project planner still sees the old date in a spreadsheet and customer service has already promised installation. There is also an open transfer from another site that could cover part of the shortage. A useful workflow links the supplier’s revised confirmation to the purchase line, identifies the affected machines, checks existing incoming supply and prepares choices for the owner who can approve cost and schedule tradeoffs.

Records, ownership, and update rules

RecordOwnerOperating rule
Purchase-order linePurchasingRetain supplier, PO and line identity with ordered quantity and the original requested delivery.
Supplier confirmationPurchasingStore the supplier’s stated date, quantity and source evidence without overwriting the internally accepted plan.
Demand dependencyPlanningLink the component shortage to specific jobs or orders and distinguish firm requirements from forecasts.
Recovery decisionPurchasing and planningRecord approved expedite, transfer, substitute or reschedule choices with their owners and costs where known.

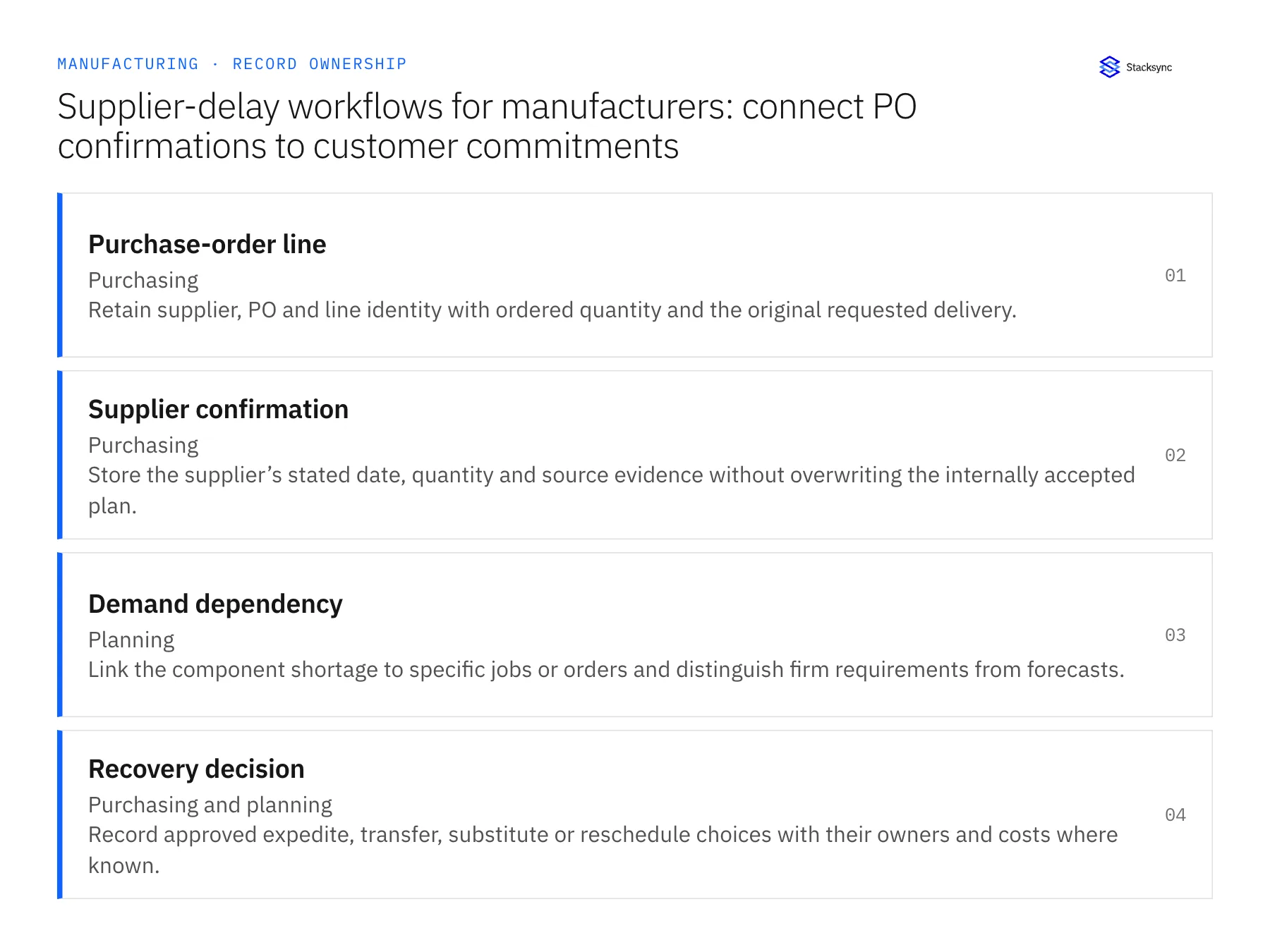

Record ownership diagram: Purchase-order line, Supplier confirmation, Demand dependency
Define the record owner and the rule before enabling updates.

Work through the process

  1. 01
    Match the changed confirmation
    Use the supplier’s PO and line references to identify the affected commitment. Compare the new information with the latest accepted confirmation. If the email describes several lines ambiguously, request clarification rather than moving every line on the order.
  2. 02
    Check existing supply before proposing action
    Review remaining PO quantities, transfers, partial receipts and already approved expedites for the affected item. Compare required dates and eligible locations. A late line does not imply that another order is needed if suitable supply is already incoming.
  3. 03
    Prepare the impact review
    Show the customer or job commitments that depend on the delayed quantity, together with available alternatives and missing information. Let planning rank affected demand and purchasing validate supplier options. Keep technical substitutions subject to the appropriate engineering or quality decision.
  4. 04
    Track the approved recovery through receipt
    Update the agreed operational records and schedule follow-up against the revised confirmation. An expedite approval is not a receipt. Close the delay case only when the required quantity is received or the affected demand has an accepted alternative disposition.

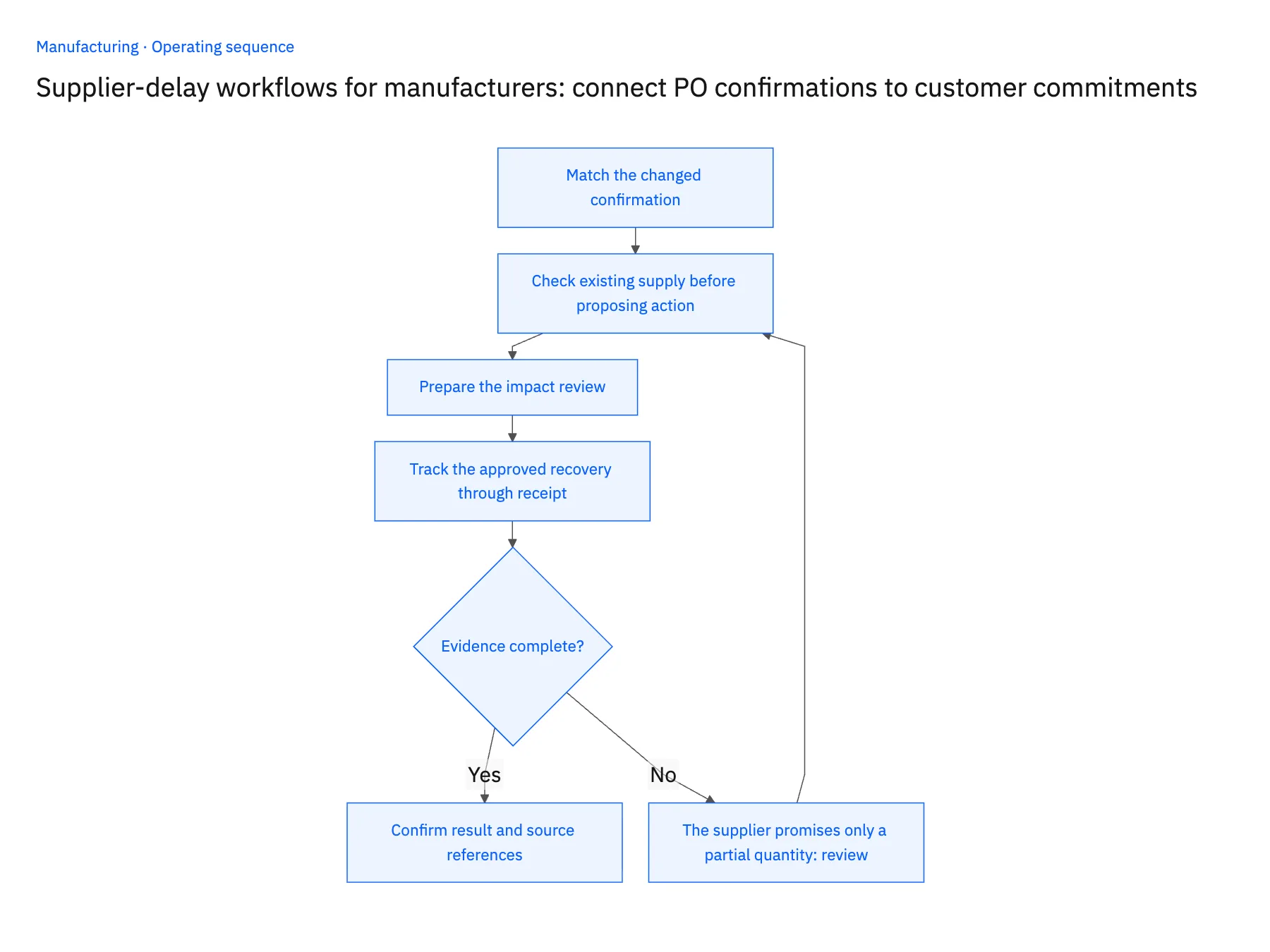

4-step operating sequence: NetSuite supplier delay workflow for manufacturing POs
Follow the operating sequence; unresolved exceptions return to a responsible reviewer.

Handle the exceptions explicitly

The supplier promises only a partial quantity

Split the confirmation into the quantities and dates actually offered. Do not mark the whole purchase line recovered because one shipment has a tracking number.

A transfer is already covering the shortage

Link the existing transfer to the case and remove the duplicate proposal from consideration. Retain who approved the allocation.

A substitute is available but unapproved

Present it as a candidate with compatibility evidence. Keep purchasing action blocked until the technical owner approves its use for the affected demand.

What to verify before expanding

  • A revised confirmation identifies the exact purchase line and affected quantity.
  • Open transfers and incoming supply are considered before another purchase proposal is prepared.
  • The customer-facing promise changes only after planning accepts the recovery plan.
  • A case cannot close solely because an email was sent or an expedite was requested.
Book a demo for manufacturing integration and automation

Connect this process to the rest of your operation

Explore Stacksync workflows and scope the records and actions against your actual systems. Book a demo with a real purchase-order line example and the exception your team handles most often, for example the supplier promises only a partial quantity.

The shared architecture guide covers record matching, ownership, and recovery across systems.

Technical references

Book a demo for manufacturing integration and automation

FAQ

Frequently asked questions

Should an agent contact suppliers automatically?
The communication channel, sender identity and approval policy should be explicitly configured. The initial pilot can prepare follow-ups for review while measuring whether the evidence and recipient are correct.
Which date should appear in the planning view?
Show the latest supplier-confirmed date and the internally accepted recovery date separately. Their difference is often the reason the case needs attention.
Which numbers show a supplier-delay workflow is working?
Count overdue confirmations, manual follow-up touches, request-to-confirmation time and reopened delay cases. Track incremental freight or buying decisions separately from administrative time saved.
