Reconcile Contractor Quotes, Approved Work, and Maintenance Invoices

Reconcile a maintenance invoice by comparing its lines with the contractor quote and purchase order that facilities and purchasing approved, then checking completion and facility acceptance evidence.

Author
Ignacio Malpartida · GTM Engineer
Published
Updated
Read time
7 min read
Reconcile Contractor Quotes, Approved Work, and Maintenance Invoices
APP TIPS

Trace the invoice back to the approved version of the work

Reconcile a maintenance invoice by comparing its lines with the contractor quote and purchase order that facilities and purchasing approved, then checking completion and facility acceptance evidence. The latest quote in a ticket is not necessarily the approved one. Preserve version references so finance can see which scope and cost were authorized.

A contractor may discover additional work during the visit. That change needs the applicable facilities and purchasing decision before it is treated as part of the approved commitment. Do not retrofit an approval by updating the original quote after the invoice arrives.

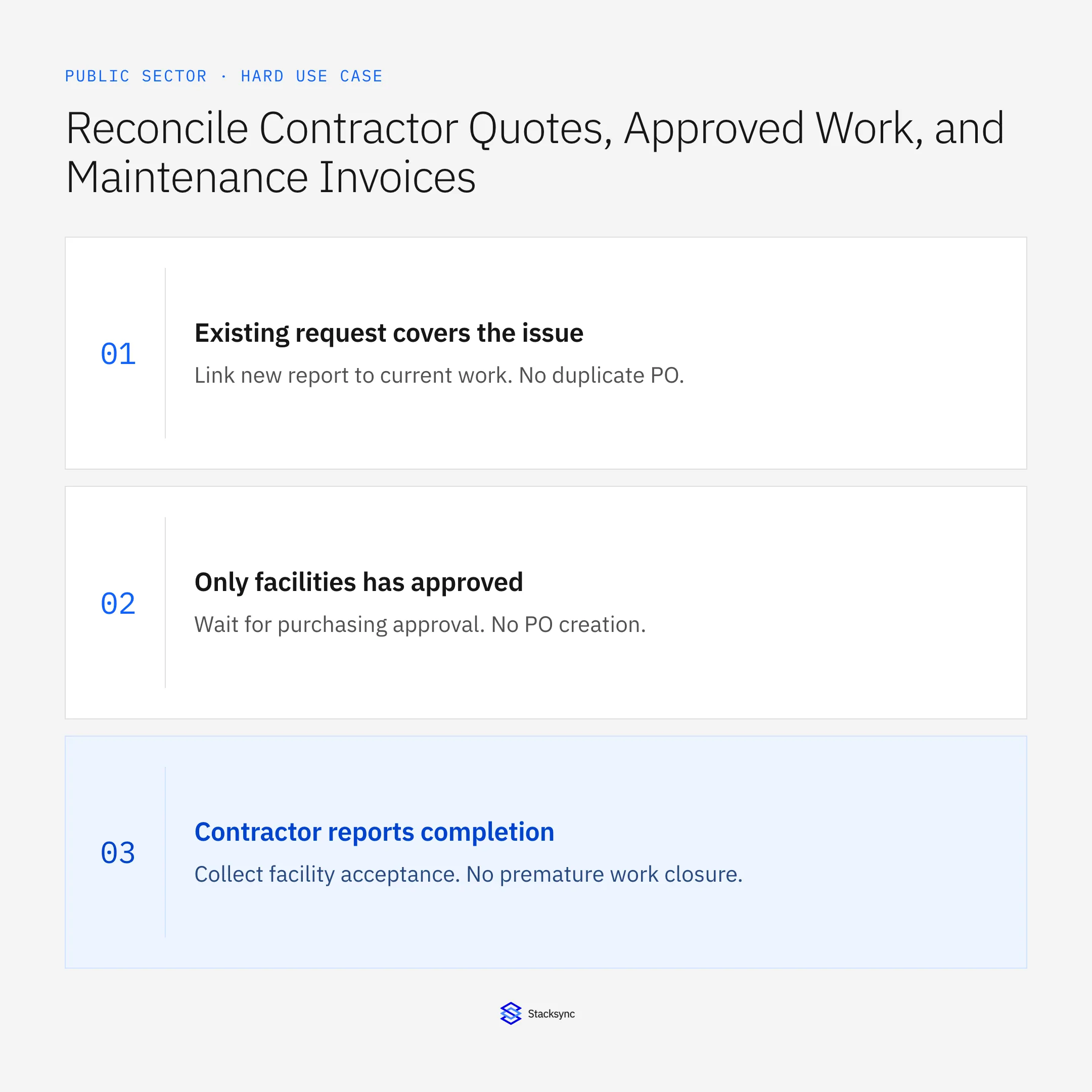

Existing request covers the issue: Link new report to current work. No duplicate PO.; Only facilities has approved: Wait for purchasing approval. No PO creation.; Contractor reports completion: Collect facility acceptance. No premature work closure.
Existing request covers the issue: Link new report to current work. No duplicate PO.; Only facilities has approved: Wait for purchasing approval. No PO creation.; Contractor reports completion: Collect facility acceptance. No premature work closure.

Evidence needed to resolve the exception

Use this exception guide when reviewing a proposed Genie workflow or investigating a case that cannot proceed confidently. The tables describe operational decisions to configure in your environment. They are not claims that a connected application automatically supplies your organization’s policies, identity mappings, or approval process.

System or ownerEvidence and responsibility
ZendeskFacility report, contractor coordination, progress updates, and facility acceptance.
SalesforceFacility asset identity.
PostgresExisting work requests, approved contractor records, progress, and completion evidence.
NetSuiteApproved purchase order and related invoice evidence.
Facilities and purchasingApproval of the contractor quote and purchasing commitment.
FinanceReview of invoice discrepancies and all payment decisions.

Required context for this workflow design.

Distinguish contractor completion from facility acceptance

The contractor’s completion note records their report of work performed. Facility acceptance confirms the required operational outcome from the facility’s side. This workflow requires acceptance before closing the maintenance request. Missing acceptance needs follow-up through Zendesk rather than an inferred sign-off based on elapsed time.

Compare invoiced quantities, hours, rates, and materials with the approved work and evidence. A matching total can still contain substituted or unsupported line items. Conversely, an apparent quantity difference may be explained by an approved change; include that reference rather than flattening the history into one final number.

Keep work closure and financial resolution linked

A facility can accept the repair while finance still needs to investigate the invoice. Track the financial exception separately but retain the maintenance request, asset, purchase-order, and acceptance references. Closing the work request must not imply that the invoice is approved for payment.

Send finance a concise packet with the approved amount, invoiced amount, line-level discrepancy, supporting evidence, and any requested clarification. If the contractor resubmits an invoice, check whether it replaces an earlier document to avoid duplicate review or payment risk. The agent can collect and compare evidence; it must never authorize payment or represent finance’s pending decision as complete.

Decision table for common exceptions

Use the condition in the first column to choose the next action. The final column describes the boundary that must remain true while the case is unresolved. Apply the organization’s actual policy and source records to the live case; do not treat an illustrative condition as proof that the condition exists.

Observed conditionNext actionRequired boundary
Existing request covers the issueLink new report to current workNo duplicate PO
Only facilities has approvedWait for purchasing approvalNo PO creation
Contractor reports completionCollect facility acceptanceNo premature work closure
Invoice includes unapproved workSend discrepancy to financeNever authorize payment

Exception decisions for facility maintenance.

The underlying facility maintenance process: check existing work, gather the quote, obtain both approvals, track and accept work, compare the invoice.
The underlying facility maintenance process: check existing work, gather the quote, obtain both approvals, track and accept work, compare the invoice.

Illustrative exception and recovery

The facility accepts completed work, but the invoice adds two hours absent from the approved quote and change history. The maintenance acceptance remains recorded while the unsupported charge goes to finance; no payment is authorized.

This example uses fictional records to show the decision logic. It is not a customer case study or a claim of measured results. In a live case, retain the actual record IDs and evidence behind each statement, and replace all illustrative quantities or timing assumptions with the approved operational inputs.

What to record before resuming

A linked maintenance record from asset and contractor quote through dual approval, purchase order, completion, facility acceptance, and any finance-owned invoice exception.

Preserve the original finding and the evidence that resolves it. Record which person or system supplied the clarification, which proposal it applies to, and the action now permitted. Do not erase the uncertainty from the history: a later reviewer needs to understand why the case paused and why it resumed.

Required systems feed case verification; missing evidence or decisions return to clarification before the workflow proceeds.
Required systems feed case verification; missing evidence or decisions return to clarification before the workflow proceeds.

Boundaries that remain in force

  • Identify the Salesforce asset and check Postgres work requests before creating another.
  • Use an approved contractor and require facilities plus purchasing approval before a NetSuite PO.
  • Track work in Postgres and updates in Zendesk; obtain facility acceptance before closing.
  • Compare invoice, approved work, and completion evidence; route discrepancies to finance and never authorize payment.

Review the case before restarting

First verify that the new evidence resolves the original blocker rather than a different issue. Then check whether the case, source records, or proposed action changed during the wait. A response attached to the right ticket can still be insufficient if it refers to an earlier proposal or leaves a required quantity, identity, or approval unresolved.

Run the relevant row from the decision table as a review scenario. Confirm that the job stops at the required boundary, asks for the specified information or decision, and resumes from the confirmed state. If a write or message may already have succeeded, inspect its destination before repeating it; if this job only prepares a draft or report, verify that it stays within that output scope.

  • Duplicate work requests and purchase orders prevented
  • Purchase orders backed by facilities and purchasing approval
  • Accepted maintenance jobs with unresolved invoice discrepancies

Track unresolved cases by their actual blocker and owner. A case waiting for clarification needs a different next action from one waiting for a confirmed result. Review the evidence when the state changes, and keep any still-unresolved completion condition visible instead of treating a successful intermediate step as the end of the work.

Give your Genie a job description. Explore Stacksync Genies.

Give your Genie a job description

Copy the job description below. It preserves the scope and decision boundaries of this use case. Configure the referenced systems, record relationships, policies, and approval owners in your workspace before enabling the job.

Facility maintenance · Hard
When a public facility reports a maintenance problem in Zendesk, identify the asset in Salesforce and check existing work requests in Postgres to avoid duplicates. Gather a quote from an approved contractor and request facilities and purchasing approval before creating a NetSuite purchase order. Track the work in Postgres and coordinate updates through Zendesk. Collect facility acceptance before closing the request, then compare the invoice with the approved work and completion evidence. Send discrepancies to finance and never authorize payment yourself.

Paste this into “Give your Genie a job description.” Explore Stacksync Genies.

Apply this in commercial flooring and interior installation: opportunity and takeoff revision

Commercial flooring applies the same approved-quote discipline to finish schedules, takeoffs, and material purchasing. Keep the accepted project scope distinct from a live proposal, then carry only the reviewed quantities and product selections into procurement.

Record to reconcileResponsible ownerRule to preserve
OpportunitySalesTrack bid status and customer contacts without replacing the approved scope record.
Takeoff revisionEstimatingRetain area, unit, waste assumption and finish selection for each phase.
Approved quote referenceCommercial administrationIdentify the accepted revision and its governing terms.

An exception to plan for: Customer changes finish in one phase. Create a scoped revision and preserve accepted selections for the other phases. Acceptance check for the pilot: A revised estimate cannot overwrite the accepted quote.

The commercial flooring and interior installation hub connects the broader operating context. These guides develop the specific record mappings and decisions for this application:

Implementation references

These first-party references document the underlying records and interfaces. The cross-system sequence, approvals, and completion rules in this article are a proposed operational configuration; validate them against your connected workspace before enabling it.

Book a demo for commercial flooring and interior installation operations

FAQ

Frequently asked questions

What does the facility maintenance workflow produce?
A linked maintenance record from asset and contractor quote through dual approval, purchase order, completion, facility acceptance, and any finance-owned invoice exception.
What should happen when the evidence is incomplete?
Keep the affected action pending and obtain the missing source evidence or required decision. Compare invoice, approved work, and completion evidence; route discrepancies to finance and never authorize payment.
